[original article] solution for MRP run purRqs instead of schedule lines

    my users open a ticket for issue with MRP result last week:

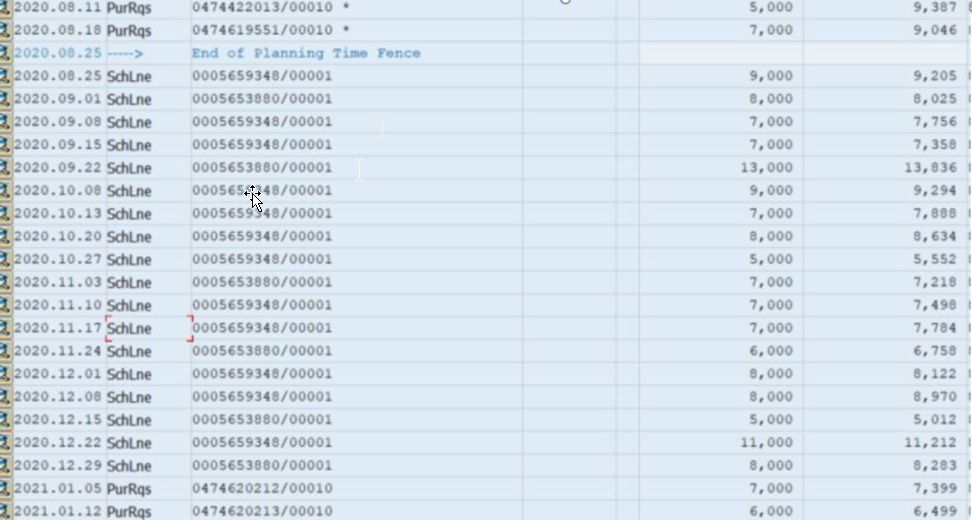

    purpqs are created instead of shedule line but it also works as schedule before,

and material is quota arrangement.

    after several days investigation, i found it related with quota arrangement, but i

still haven't searched any useful official document of explanation.

    Anyhow here's steps how i solve this case:

    1. MEQ7- Delete exist Quota Arrangement

    2. ME01 - Delete exist source list

    3. ME01 - Maintain source list Again

    4. MEQ1 - Maintain Quota again

    5. MD02 - Run MRP
